Day-by-day timeline for kitchen cabinet painting — off-site vs on-site, spray vs brush, and dry time requirements.
Our local New Jersey clients often ask us: how long does cabinet painting take?
If you are wondering exactly how many days cabinet refinishing takes, a standard project typically requires just five to seven business days.
We focus on minimizing the chaos by doing the heavy lifting off-site. The on-site disruption is usually limited to a short two-day window.
Let’s look at a realistic daily schedule, review the science behind paint drying, and explore the specific factors that might extend your project.
Typical Timeline (20-door kitchen)
A typical 20-door kitchen cabinet painting project takes exactly five to seven business days. Our team completes the majority of the heavy sanding and spraying off-site to keep your kitchen functional.
This off-site process keeps toxic dust out of your home. You can actually still use your kitchen for light meal prep during the first three days.
- Phase 1 (Day 1): We conduct a walkthrough, remove all hardware, label the doors, and transport them off-site.

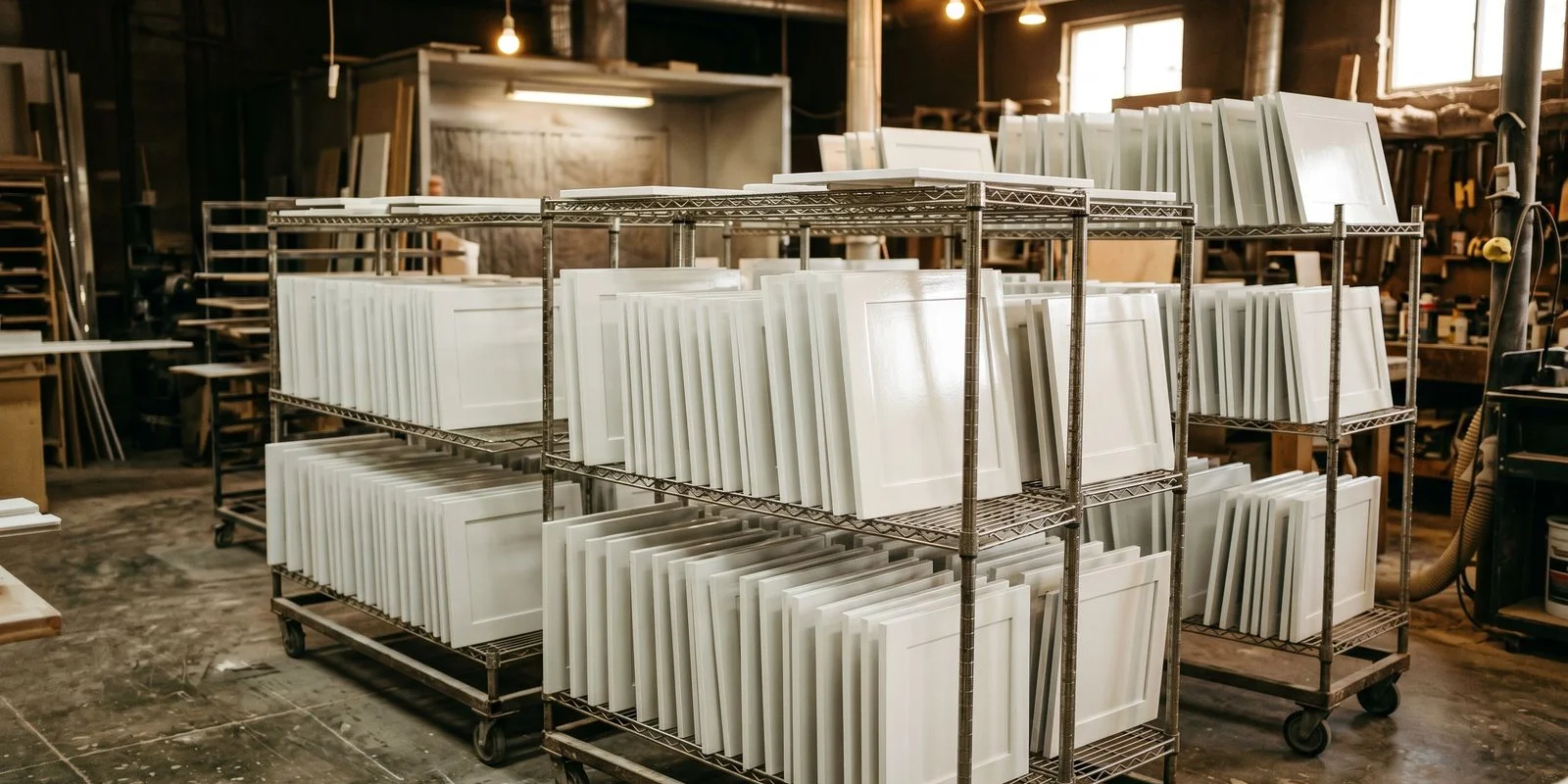

- Phase 2 (Days 2 to 3): Off-site door prep involves a deep clean, sanding, caulking, and the first coat of primer.
- Phase 3 (Days 4 to 6): On-site box prep starts by masking surrounding surfaces, sanding, and priming. We then apply two spray coats, sanding carefully between each layer.
- Phase 4 (Days 7 to 8): The final topcoat goes on the doors and the on-site box frames.
- Phase 5 (Days 9 to 10): Doors get a full cure day before our crew rehangs them, reinstalls the hardware, and does a final walkthrough.
Why Dry Time Matters
Cabinet paint requires adequate dry time so the finish can resist chipping, peeling, and permanent hardware imprints. We use modern, high-performance coatings that need specific conditions to cure properly.
A product like Benjamin Moore Advance might feel dry to the touch in just four hours. But Benjamin Moore’s technical data sheet shows it needs a full 16 hours before it can handle a second coat. Painting experts warn that high humidity in New Jersey during the summer can push that recoat window past 24 hours.
Our crew relies on top-tier products, and managing the total kitchen cabinet paint duration during the curing phase is critical for a durable finish.
| Cabinet Paint Product | Recoat Time | Full Cure Time |
|---|---|---|
| Benjamin Moore Advance | 16 to 24 hours | 7 to 14 days |
| Sherwin-Williams Emerald Urethane | 4 to 16 hours | 7 to 30 days |
Rushing this chemical process causes major headaches down the road. You can easily test readiness by gently pressing a fingernail into an inconspicuous edge, a standard painter’s trick. If it leaves a mark, the paint needs more time.
Skipping the proper dry times leads to severe finish failures:
- Doors sticking together and peeling when stacked.
- Metal hardware leaving permanent dents in the soft paint.
- Edges chipping easily within the first few weeks of use.
- The finish never reaching its intended maximum durability.
We typically reinstall your doors at the two or three-day mark. The paint will be safe to handle gently at this stage.
Homeowners should plan to treat the cabinets very lightly for the first two weeks while the full cure happens. Do not install heavy peel-and-stick bumper pads or vigorously scrub the doors until day 30.
What Extends the Timeline
Several variables will extend your cabinet painting timeline beyond the standard five days. We always assess the wood type, the kitchen size, and the desired color shift before setting a firm schedule.
Large kitchens with more than 20 doors will automatically add two to three days to the job. Bundling bathroom vanities into the same project will also require an extra day or two.
Our team pays special attention to the original wood grain. Oak cabinets feature deep, porous grains that look terrible if simply painted over.
Dealing With Oak and Color Changes
We apply a specialized product like Aqua Coat White Cabinet Grain Filler to hide deep oak pores. The manufacturer notes this water-based gel takes about 45 minutes to dry between applications. The doors then need an overnight cure before sanding.
Drastic color changes also demand extra time and materials. Moving from a dark cherry stain to a bright white finish requires a heavy stain-blocking primer, like a dewaxed shellac, to prevent the dark wood tannins from bleeding through the fresh paint.
Here is how common variables affect your schedule:
- Oak Grain Filling: Adds 2 to 3 days for multiple filler coats to cure.
- Dark to Light Color Shift: Adds 1 day for stain-blocking shellac primers.
- Extra Vanities: Adds 1 to 2 days for additional prep and spraying.
- Full Restorations: Upgrades the timeline from days to weeks for chemical stripping and custom staining.
See our interior painting service for cabinet specifics, or review our cabinet painting cost guide for pricing details. Contact us today to schedule a walkthrough, and we will give you an exact cabinet painting timeline for your specific kitchen.
